The Rosário Project
Fully integrated.
Mine to port.
A flat, free-digging open pit in the state of Piauí, paired with sealed roads and a port less than two hours away. The shape of a low-cost producer.
Mining Area & Rights
- 4 mineral rights covering 7,800 hectares
- Target mine life: 20–25 years
- Free-digging open-pit, flat geography
- Shallow 20 m target depth · strip ratio ~0
Operation
- First production: late 2028
- 2028–2030: 1–4 Mtpa
- 2031 onward: 5–10 Mtpa
- Product quality: Fe 62–65% concentrate
Integrated Logistics
- 100 km tarmac haul (50-t trucks)
- Loading port: Luís Correia, Piauí
- Phase 1 — Transshipment (2026)
- Phase 2 — Pier loading · 18 m draft · Capesize
Tenement Upside
Significant additional resource upside.

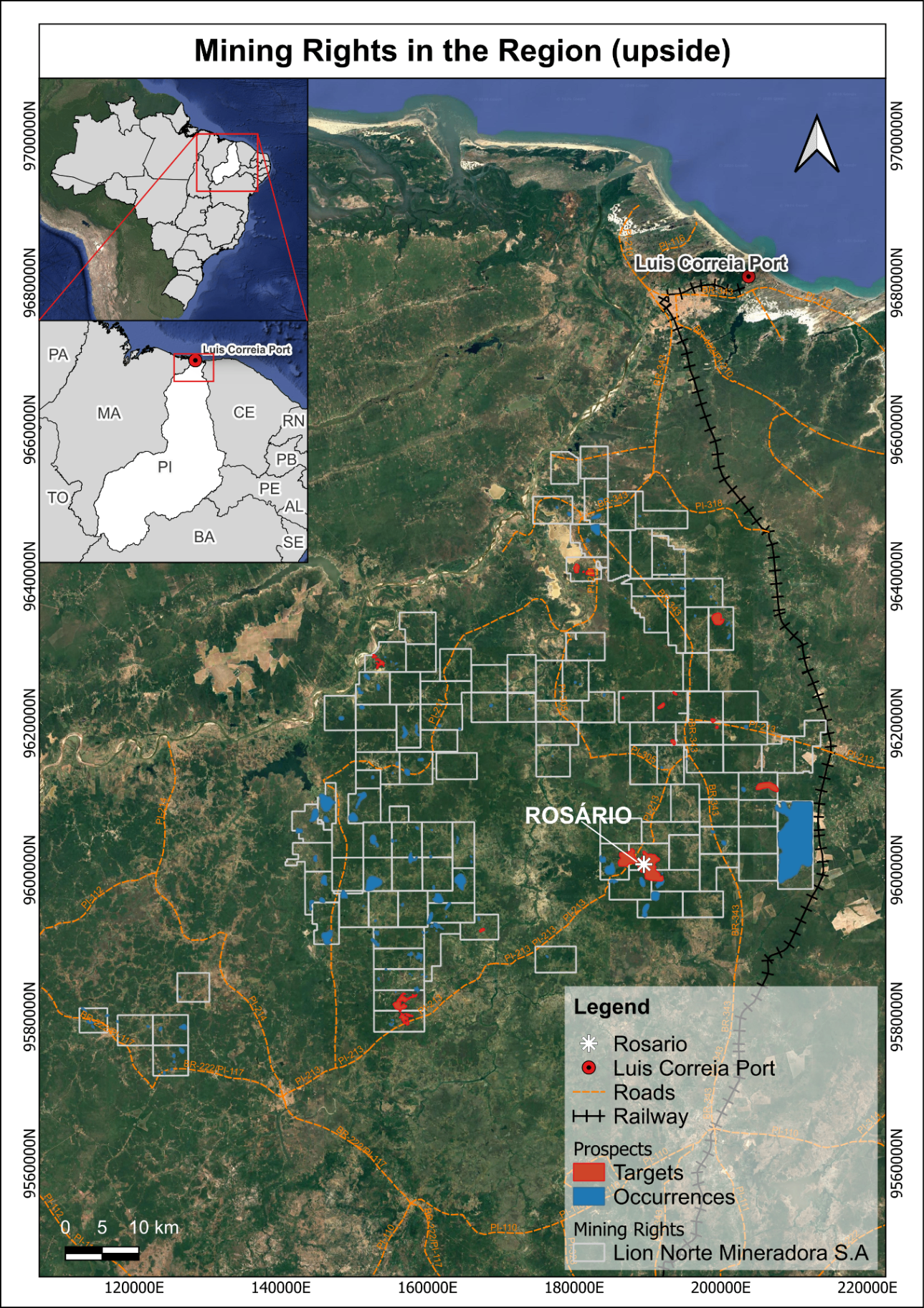

Lion Norte holds a first right of refusal to acquire 108 additional tenements over 202k hectares, an area roughly the size of Luxembourg.

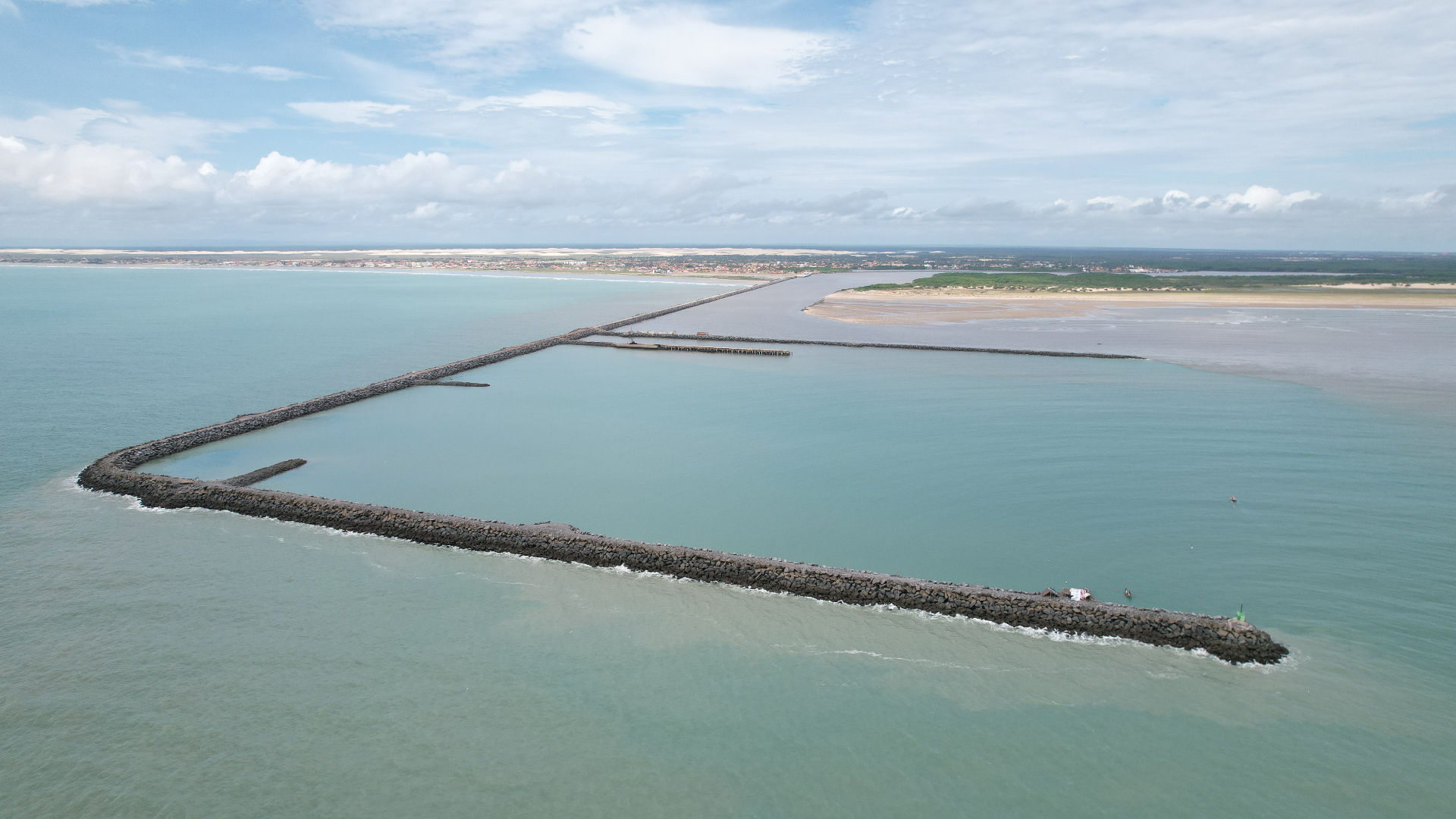

Porto Piauí · Luís Correia
First shipment scheduled for 2H 2026.
Investe Piauí is 100% owner of the port and a cornerstone investor in Lion Norte. Mini-bulker loading piers, 3.6 km access bridge and an iron-ore stockyard, with future plans for Capesize loading at berth.
Technical Information
Drilling complete. Resource certification ahead of IPO.
200–250 Mt
Expected resource (inferred + indicated)
150+
Drill holes completed
1,100+
Samples taken
62%
Preliminary Fe in final product
Maps

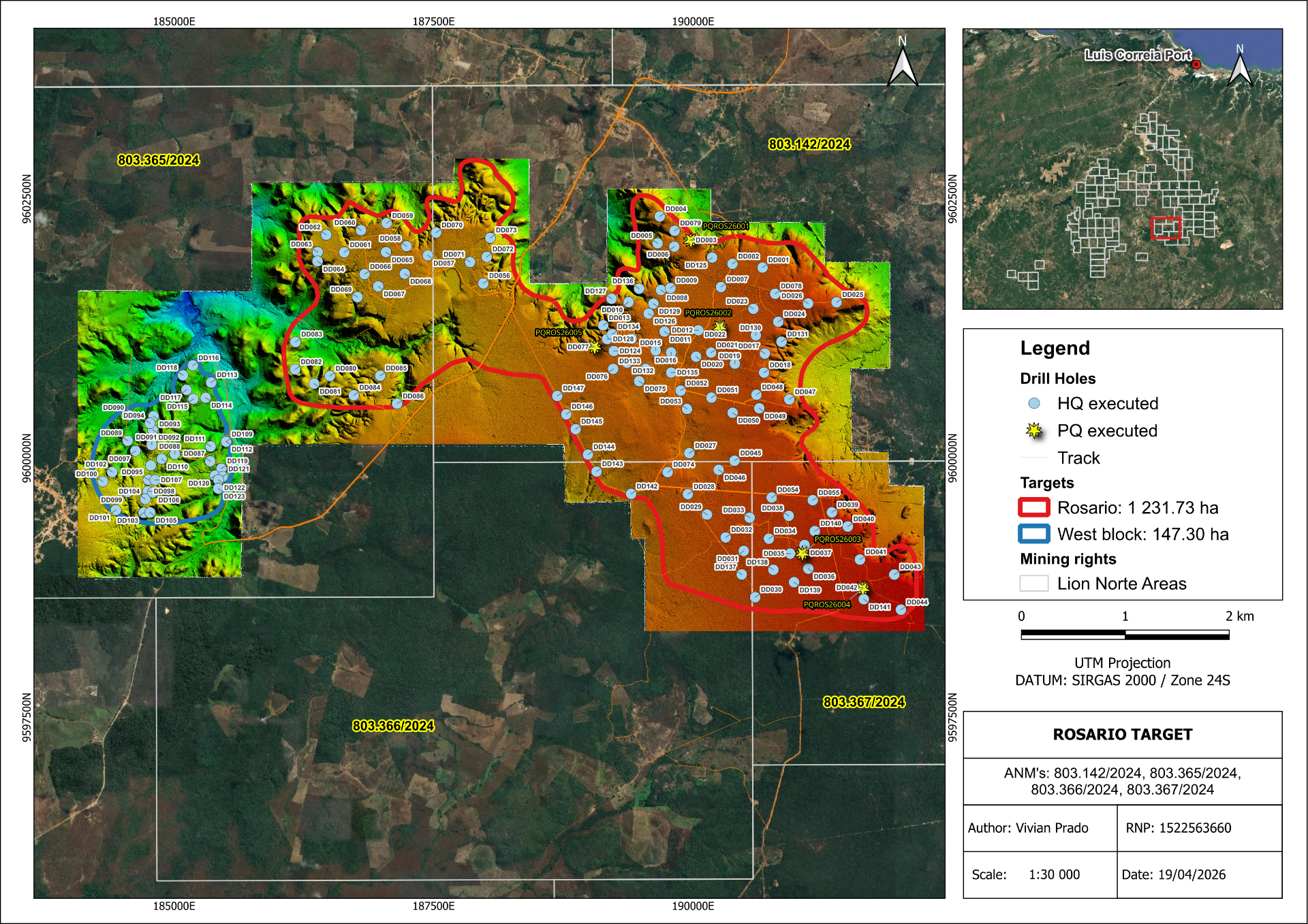

Drilling Campaign
Timeline & Key Milestones
From discovery to first production.
PHASE 01
2024–2025
Exploration
- — Sep 2024 — Discovery & mapping; surface and trench sampling
- — Apr 2025 — Exploration NI 43-101 certification
- — May 2025 — Investe Piauí becomes 5% shareholder
- — Aug 2025 — Base set up in Cocal; team recruited
PHASE 02
2025–2026
De-Risk Studies
- — Nov 2025 — Drilling campaign starts
- — Jan 2026 — MoU with Porto Piauí signed
- — Mar 2026 — Drilling complete; geo-metallurgical studies
PHASE 03
2026
IPO — London Stock Exchange
- — Aug 2026 — Resource NI 43-101 certification; PEA
- — Q3 2026 — Anchor investors commit
- — Q4 2026 — Initial Public Offering
PHASE 04
2026–2027
Feasibility & Approvals
- — Q4 2026 — Pre-Feasibility Study begins
- — H1 2027 — Licences, permits, final engineering
- — H2 2027 — Iron Ore Terminal agreement with Porto Piauí
PHASE 05
2028
Construction & Start-Up
- — Q1 2028 — Installation; environmental licence (LI)
- — H2 2028 — Operational environmental licence (LO)
- — Q4 2028 — First production
